Home News Products News Installation Services for VFD Panels in Commercial Buildings
Technical Guide · Low Voltage Switchgear

Installation services for VFD panels in commercial buildings: on-site installation, electrical room setup, MCC integration, and commissioning for offices.

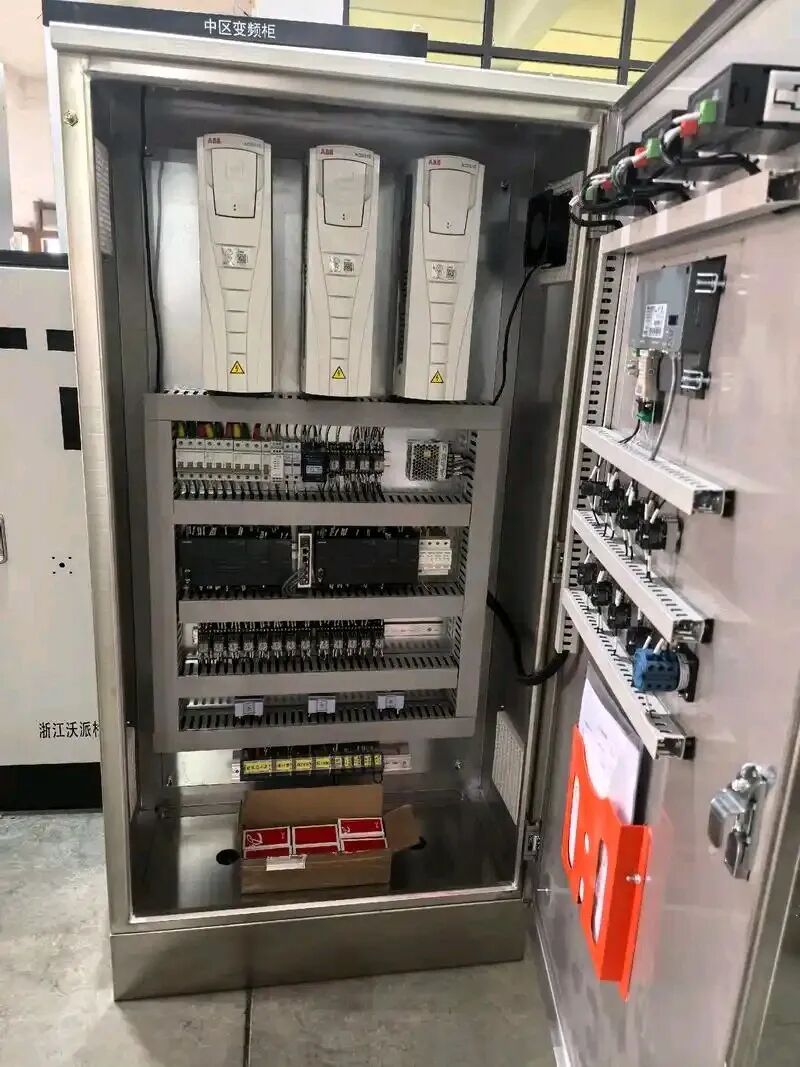

vfd panel_in_door-open_ABB_06

A vfd control panel that drives an HVAC fan, a chilled water pump, or an escalator in a commercial building is a long-term asset. The way it is installed decides whether it lasts twenty years or fails in two. Cut corners on the room, the cabling, the grounding, or the commissioning, and the panel pays the bill in nuisance trips and premature drive failures.

This guide covers installation services for VFD panels in commercial buildings, from the first site survey to the final handover document. The VFD panel you ordered matters less than the way it is installed, commissioned, and documented.

Key Takeaways

  • The room is part of the panel: A vfd control panel in a commercial building needs an electrical room that handles heat, dust, humidity, and cable access. Spec the room before the motor control panel.
  • Routing and shielding are installation work: Drive output cables radiate; the route to the motor must keep them away from signal cables or the building network will see noise.
  • MCC bucket integration is a service decision: Whether the drive lives standalone or in a motor control center bucket changes the installation plan, the access, and the maintenance procedure.
  • Commissioning proves the installation: A loaded run and a harmonic measurement at the input terminals confirm that the work was done right, before the building goes live.
  • Documentation closes the job: As-built drawings, parameter files, and test records are the warranty for the next ten years of operation.

Site Survey and Electrical Room Planning

The site survey decides everything the installation can and cannot do. The room is too small, the cable entry is in the wrong place, the supply is shared with harmonic loads, the floor is uneven, the ventilation is weak. Each constraint pushes a design choice that cannot be reversed on site. IEC 61439 design verification for the motor control panel and the vfd control panel relies on the room supporting the rated ambient temperature.

Pre-Installation Audit

What the installer verifies before delivery arrives

A VFD panel installation in a commercial building starts with a room survey, not a forklift. Confirm the room dimensions, the cable entry positions, the supply impedance, the ambient temperature profile, and the load schedule.

  • Room volume sized for the heat load and the access path
  • Cable entries in the planned base or top plates, sealed against dust
  • Supply impedance measured at the incoming, with a written record
  • Floor loading rated for the panel and the future expansion
Electrical Room commercial building electrical room with ATS panel and VFD panel installed during installation project

For an office tower, the room is usually on a service floor or basement, and the access path must fit a crated VFD panel through a lift or a stairwell. For a hospital, the room may need separate feeds from the standby generator and the UPS. For a hotel, the load schedule is dominated by HVAC and kitchen extract fans. The survey produces the assumptions the installation will run on. World Bank commercial building energy guidance notes that motor control panel and vfd control panel installation quality is a top driver of urban facility uptime.

Mechanical and Thermal Installation of the VFD Control Panel

Mechanical installation is the part that looks simple and is not. A vfd control panel that is not level will not align with the busbar.

A panel mounted on an uneven base will vibrate, and the vibration loosens the terminals. A panel that is too close to a wall cannot be wired from behind, and the installer is forced to leave cables that nobody can service later.

VFD panel door open showing drive unit and internal wiring during installation and commissioning
Mechanical Site Work

Four mechanical rules that decide the panel's lifetime

1
Base and levelThe panel sits on a level base, plinth, or floor channel. A spirit level confirms plumb on all sides before any cable is connected.
2
Ventilation clearanceDrive heat exits the panel through vents or fans. The installer leaves the manufacturer's specified clearance on the vented sides, not a single centimetre less.
3
Cable accessTop or bottom entry is decided in the survey. Cables enter through glands, never through knockouts, and the routing is documented before termination.
4
Earthing and bondingThe panel is bonded to the building earth grid with a dedicated conductor, not shared with the cable tray or the structural steel.

Thermal installation matters more than mechanical for the drive's life. A vfd control panel in an undersized or unventilated room cooks itself.

The electrical control panel fabrication standard the room must meet is the same standard the panel was built to in the factory. The installer verifies the room before the motor control panel is energized.

Power and Control Cable Routing

Cable routing decides the noise budget for the whole installation. Drive output cables carry high-frequency switching transients that couple into any signal cable routed alongside them.

A vfd control panel that passes its factory test can fail its site acceptance test because the cables were laid next to the network cables through a shared tray.

The installation plan for a vfd control panel separates the three cable families: power input, drive output to the motor, and control or network cables. Each family has its own tray, its own segregation distance, and its own routing through the building.

Cable family Carries Segregate from Minimum separation
Power input 50/60 Hz from the incomer to the VFD Control and network cables 300 mm parallel run, 1 m at crossings
Drive output to motor High-frequency PWM between 1 kHz and 16 kHz All other cables, especially signal and Ethernet 300 mm parallel run, separate tray, 90 degree crossing only
Control and network 24V signals, Modbus, Profinet, Ethernet Power and drive output cables 300 mm parallel run, 90 degree crossing only, no parallel trays

Shielded cable from drive to motor, grounded at both ends, is the standard.

The installer verifies shield termination, not just continuity, and documents the separation distance for the handover record.

VFD Panels and the Motor Control Center Bucket

What does mcc stand for in electrical? MCC stands for motor control center, the line-up that holds starters, protection, and control for a bank of motors. Each motor sits in a withdrawable unit called a bucket, which carries the breaker, contactor, and overload, and can be removed for maintenance while the rest of the line-up stays live.

A VFD panel can live standalone, or it can be installed inside an MCC bucket. The two arrangements have different installation implications.

Commercial Application commercial building power distribution and VFD panel installation in office tower electrical room
Standalone vs Bucket

When the drive lives in an MCC bucket

A standalone VFD panel needs a footprint of its own and a clear front access for service. A bucket-mounted VFD lives inside the existing MCC, which saves floor space but requires careful coordination with the MCC manufacturer and the building operator.

  • Standalone for large drives, ease of access, and hot rooms
  • MCC bucket for compact multi-motor line-ups and fast swap-out
  • Hybrid for plants that mix both arrangements in one room

What is motor control centre in practice? It is the distribution point where every motor in the plant gets its protection, control, and monitoring from one line-up of buckets. The mcc in electrical design is the backbone of the motor plant, and the VFD bucket sits alongside the other motor buckets in the same line-up.

Electrical control panel fabrication quality decides how long either arrangement survives. Busbar sizing, cable segregation, and thermal management in fabrication determine whether the drive runs cool for a decade or fails in two years.

Loading, Commissioning, and Harmonic Verification

Commissioning is the proof that the installation works. A vfd control panel that is energized for the first time without a load test is a panel that has never run.

The installer runs a loaded no-drive test, then a drive test at low speed, then a drive test at full speed, and finally a harmonic measurement at the input terminals.

Three checks define a successful commissioning:

  • Motor runs in both directions at the speed reference set by the building management system.
  • Drive reports no faults and the input current matches the motor nameplate within tolerance.
  • Total harmonic distortion at the input is within the contract specification, typically 5 percent or less for office and hotel loads.
!
Common Mistake Commissioning the drive on no load and calling it done. A drive that runs on no load will behave differently on a real fan or pump. The full load step test is the only test that proves the installation handles the real load.

The commissioning record goes into the as-built documentation. It is the warranty for the next ten years of operation, and the reference for every future change.

i
What the handover contains The as-built package should include the single-line diagram, the cable schedule, the parameter file, the test records, and a photo set. The motor control panel and the vfd control panel each get their own handover file.

Choosing Installation Service Providers

Control panel manufacturers who also install provide a single point of responsibility. The same team that built the panel tests it on site, knowing what to look for because they designed the panel.

Ask the installation service provider for a written plan covering the survey, the mechanical work, the cabling, the commissioning, and the documentation. The plan names the engineer who signs the as-built drawings, and the date the documentation is delivered.

For installations that involve standby generation, an automatic transfer switch is usually part of the same electrical room. Its installation follows the same standards as the vfd control panel, and its commissioning must happen alongside the drive test. IRENA commercial building energy analyses confirm the same installation-quality link to operating cost.

For projects that need the wider motor line-up, the motor control center buyer guide covers the selection logic for the MCC, and the common MCC panel problems post covers the most frequent site issues. For the procurement side of the VFD panel itself, the VFD panel buyer guide is the reference.

Frequently Asked Questions

What does installation of a VFD panel include?
A vfd panel installation covers site survey, mechanical mounting, power and control cable routing, bonding and earthing, ventilation verification, drive parameter setting, loaded commissioning, harmonic measurement, and as-built documentation handed over with the unit.
How long does a commercial building VFD panel installation take?
A single standalone vfd panel in a prepared room takes two to three working days including commissioning. An MCC bucket retrofit takes longer because the bucket integration, withdrawal testing, and coordination with existing protection are added steps.
What is the difference between a vfd panel and a vsd control panel?
There is no functional difference. vfd stands for variable frequency drive, vsd for variable speed drive. The two terms are used interchangeably to describe an electronic motor speed control. The vfd panel board that houses the drive, the protection, and the bypass is the same for both names.
What is a motor control center bucket?
A bucket is the withdrawable unit inside an mcc that holds the starter or drive for one motor. It plugs into the MCC busbar, can be pulled out for service, and lets one motor be isolated without shutting down the whole line-up.
What does mcc stand for in electrical work?
mcc stands for motor control center, the assembly that houses starters, protection, and control for a bank of motors. Each motor sits in a withdrawable unit, and the line-up is the backbone of the plant or building motor distribution.
What electrical control panel fabrication standards matter during installation?
The panel was built to a fabrication standard such as IEC 61439 in the factory. The site installation preserves that standard by following the same busbar torque, cable termination, and earthing procedure, and the as-built record documents the actual values used on site.
How do I find installation service providers?
Use control panel manufacturers who also install, so the same team that built the panel commissions it. Check the on-site team for IEC 61439 familiarity, written commissioning procedures, and the ability to deliver as-built documentation within two weeks of the load test.

Final Thoughts

Installation services for VFD panels in commercial buildings decide the panel's lifetime more than the panel itself. A good installation with a poor panel outlasts a poor installation with a good panel, and the documentation is what proves both.

Send Giantele your single-line diagram, the electrical room layout, and the load schedule. We return an installation plan with the survey checklist, the cable routing diagram, the commissioning procedure, and the as-built template for the handover.

Get an Installation Plan

Send your single-line diagram, electrical room layout, and load schedule. Giantele returns a survey checklist, cable routing plan, and commissioning procedure.
