Renewable energy sounds simple on paper. Solar panels generate DC, inverters convert it to AC, and motors run. In practice, the gap between a solar array and a working pump station is filled by a motor control panel that nobody specified until commissioning week. You end up with voltage excursions, nuisance trips, and a control system that fights the inverter instead of cooperating with it.
Motor control panel integration services close this gap before it opens. They put the panel designer, the renewable energy contractor, and the end user in the same specification discussion from day one. The result is a panel that starts motors smoothly on inverter power, switches between solar and grid without dropping loads, and protects equipment that cost six figures to install.
Key takeaways
- Renewable integration is a panel design problem: Solar inverters and wind turbines deliver power differently than grid transformers. Your motor control panel must handle voltage swings, frequency variations, and source switching that grid-only panels ignore.
- Automation control panel logic makes or breaks renewable projects: The PLC program that decides when to run pumps on solar, when to switch to grid, and when to shed loads determines whether your renewable system runs reliably or trips constantly.
- Pump control panel applications dominate renewable water projects: Solar-powered borehole pumps in Kenya, wind-driven irrigation in Morocco, and hybrid-grid lift station control panels in Indonesia all need panels designed for variable input power.
- ATS integration is mandatory for hybrid systems: A control panel without automatic transfer between renewable and grid sources leaves your pumps dead every time clouds cover the solar array.
- CE certified, IEC 61439 compliant: Giantele renewable energy motor control panels carry CE certification and are designed for solar, wind, and hybrid applications across Africa, the Middle East, and Southeast Asia.
Why renewable energy needs different motor control panel design
A grid-fed motor control panel assumes stable voltage and frequency. A 400V motor expects 400V plus or minus ten percent. A 50Hz contactor coil expects 50Hz. Grids deliver this by design. Solar inverters and wind turbines do not.
An off-grid solar system with battery storage varies its output voltage by 10-15% as battery state of charge fluctuates. A wind turbine changes frequency with gust speed before the inverter catches up. An industrial control panel designed for grid power trips its undervoltage relay every time a cloud passes. One designed for renewable integration widens its protection tolerance, adds time delays to ride through transient dips, and coordinates with the inverter's own protection curve.
Grid vs renewable: what your panel must handle differently
- Voltage tolerance: Grid panels expect stable 400V plus/minus 10%. Renewable panels accept 340-460V without tripping, with programmable time delays on undervoltage.
- Frequency ride-through: Wind turbine output frequency swings during gusts. Panel protection relays need wider frequency windows or response delays measured in seconds, not cycles.
- Source synchronization: When an ATS switches between solar and grid, the panel must coordinate the transfer so motors do not experience out-of-phase reconnection that damages windings.

Automation control panel design for renewable energy integration
An automation control panel for renewable energy does more than start and stop motors. It manages the energy source. When solar irradiance drops, it decides which pumps keep running and which shed load. When battery voltage falls below a threshold, it commands the generator start or switches to grid. These decisions live in the PLC program, not in the contactor wiring.

PLC control panel design for renewable energy: four tasks your program must handle
Automated control systems for renewable energy must handle the edge cases. What happens when battery voltage is at 48.2V and the cutoff is 48.0V? The PLC enters a hysteresis band and holds the last state. What happens when the grid returns after a four-hour outage? The panel waits 180 seconds for voltage stabilization before reconnecting motors, preventing the inrush current that trips the main breaker. These details are not in the inverter manual. They are in the panel designer's integration specification.
Pump control panel applications in renewable water systems
Solar-powered water pumping is the fastest-growing renewable application in Africa and Southeast Asia. A pump control panel for a solar borehole in northern Kenya runs differently than one for a wind-powered irrigation system in coastal Morocco. The panel design changes with the energy source.
| Energy source | Panel requirement | Typical pump type | Key control challenge | Solution |
|---|---|---|---|---|
| Solar PV only | DC-compatible VFD or DC pump controller | Submersible borehole | Power drops to zero at night | Daytime storage tank, no battery needed |
| Solar + battery | AC soft starter with wide voltage tolerance | Surface centrifugal | Battery discharge depth management | PLC-controlled load shedding at 40% SOC |
| Wind turbine | Frequency-tolerant overload relay | Irrigation booster | Frequency swings during gusts | Delayed trip on frequency deviation |
| Hybrid solar-grid | ATS-integrated duplex pump panel | Community water supply | Source switching without water hammer | Soft stop/start during transfer |
A sump pump control panel on a solar-powered drainage system faces its own challenge. The pump runs intermittently based on float switch level. On grid power, it starts whenever the float triggers. On solar, it should run during peak sun hours if possible. The PLC delays non-critical sump pumping to midday when solar output peaks. This saves battery cycles for critical loads at night. Simple logic, big impact on battery life and system reliability.

Duplex pump and lift station control for renewable projects
A duplex pump control panel on a hybrid solar-grid system runs the duty pump on solar during the day and the standby pump on grid at night. Automatic alternation evens out the wear. The panel's PLC tracks running hours per energy source and rotates pumps accordingly.
A lift station control panel in an off-grid solar community in Uganda needs different logic than one on municipal power. The solar lift station fills a holding tank during daylight. At night, it runs only on high-level alarm, using battery reserve. The panel's priority logic makes this decision autonomously.
Without this integration, the lift station either drains the battery bank overnight or stops pumping entirely after sunset. Both outcomes are unacceptable for a community of 5,000 people.

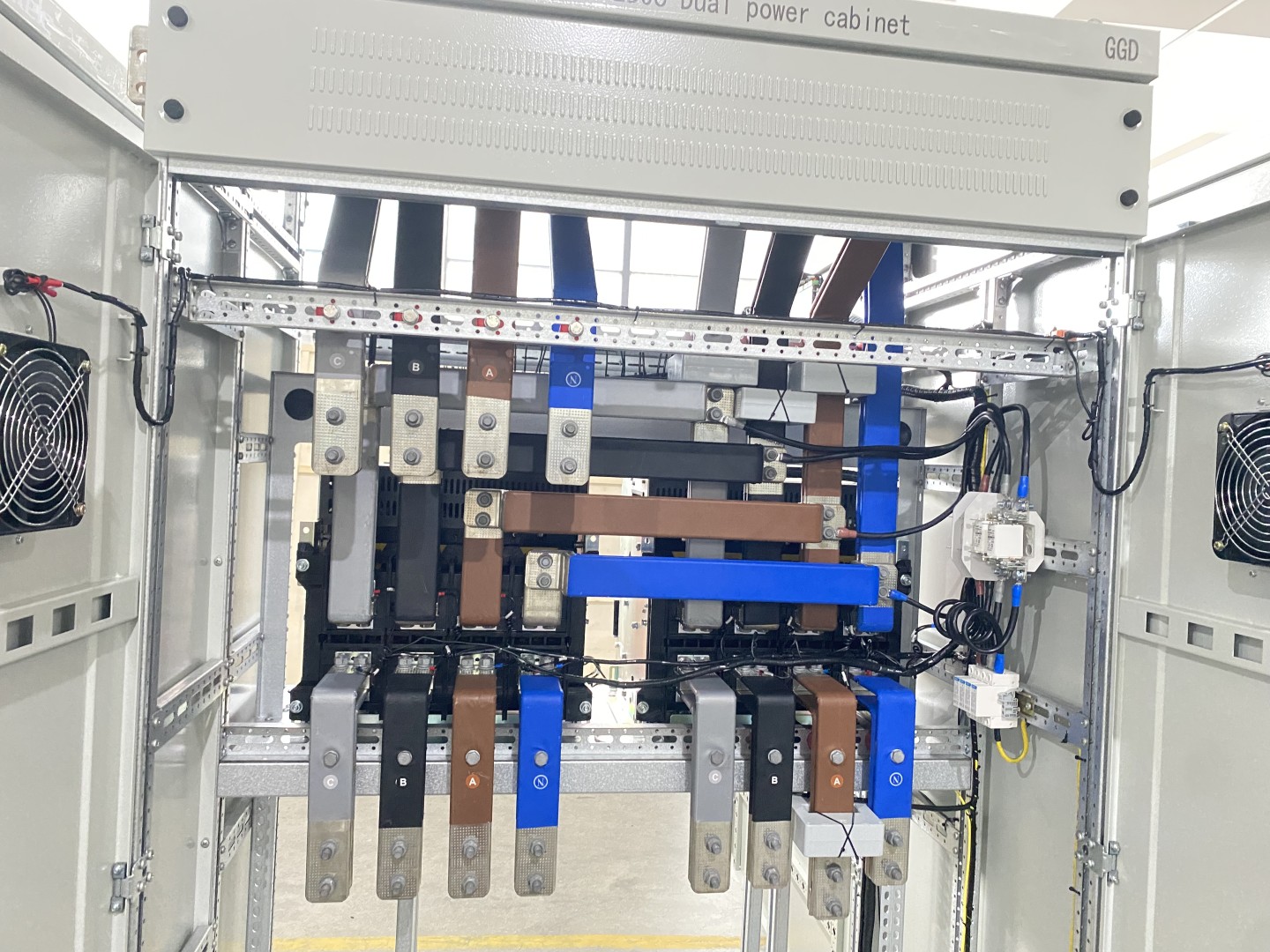

Control panel layout design for hybrid renewable-grid installations
Control panel layout design for hybrid systems must physically separate grid-connected and renewable-source components. A single enclosure with interleaved grid and solar feeders creates a safety hazard during maintenance. The technician isolates the grid breaker but the solar inverter continues feeding the DC bus.

Panel layout: three physical rules for hybrid renewable systems
Electrical control panel design for renewable integration must also handle the grounding scheme. Solar arrays are typically ungrounded or resistance-grounded on the DC side. Grid transformers are solidly grounded on the AC side. The panel's grounding bus must accommodate both without creating ground loops that trip residual current devices. This is not a detail. It is the reason many renewable projects fail their first ground-fault test.
Manufacturing control systems for renewable energy equipment
Manufacturing control systems for renewable energy production lines need their own motor control integration. A factory producing solar mounting structures in Kenya runs roll-forming machines, punch presses, and galvanizing lines. These are motor-driven loads that benefit from renewable power integration.
A VFD control panel in a manufacturing plant powered by solar reduces energy consumption by matching motor speed to process demand. A 50Hz fixed-speed fan running at 40Hz through a VFD draws roughly half the power. On a solar-powered system, that 50% reduction means the same PV array powers two production lines instead of one. The VFD investment pays back in reduced solar array size, not just in electricity savings.
Automatic power factor correction matters even more on renewable systems. Solar inverters produce active power (kW) but not reactive power (kVAR). Motors still need reactive power. If the grid provides it, you pay for kVAR demand. An Static Var Generator panel supplies reactive power locally, eliminating kVAR charges and reducing the inverter's apparent power burden. According to IRENA, power factor correction in solar-hybrid industrial systems typically recovers 8-15% of inverter capacity that would otherwise be wasted on reactive power delivery.
Frequently asked questions
What motor control panel integration services do renewable energy projects need?
Can an automation control panel manage solar and grid power automatically?
How does a pump control panel work with solar power?
What PLC control panel design features does a renewable system need?
Can you integrate a duplex pump control panel with a hybrid solar system?
How does control panel layout design differ for renewable energy?
Are Giantele renewable energy control panels CE certified?
Final thoughts
Motor control panel integration for renewable energy is not about building a different panel. It is about building a smarter one. The same contactors, the same busbars, the same enclosure. But the protection settings, the PLC program, the ATS coordination, and the factory testing all change because the energy source changed.
Send Giantele your renewable energy project specification: solar array capacity, motor list, and site conditions. Our engineering team returns an integration proposal with panel design, PLC functional description, and budget pricing within 48 hours.
Get a Renewable Energy Panel Integration Proposal
Send your solar or wind project specs plus motor list. We return a verified integration design with panel layout and budget within 48 hours.
